Custom Home Building Process: 9 Steps From Lot to Keys
A step-by-step guide to the custom home building process, from budget and lot to final walkthrough. Includes a new home construction checklist.

Ressio Staff
September 9, 2026
You've decided to build instead of buy. Now how do you get from today to the day you get keys?
The custom home building process runs in a sequence. Nine phases, each with decisions that cost little when you make them early and a lot when you make them late.
This guide walks through all nine: what happens in each phase, what you'll be asked to decide, and where budgets tend to break. If you're the builder on this project, it's also the explainer your clients keep asking for so you send them here instead of writing it yourself for the fifth time this month.
How long does the custom home building process take?
Construction alone takes most custom homes seven months to over a year. Census Bureau figures show wide spread: about a quarter of contractor-built homes finish in four to six months, while 29% take 13 months or more. Design and permitting happen before any of that.
The gap between custom and production building is stark. Here's the Census Bureau's Survey of Construction data for homes completed in 2024, measured from the day ground breaks:
| Time from start to completion | Contractor-built (custom) | Built for sale (production) |
|---|---|---|
| 3 months or less | 9% | 14% |
| 4 to 6 months | 24% | 55% |
| 7 to 9 months | 22% | 19% |
| 10 to 12 months | 16% | 6% |
| 13 months or more | 29% | 6% |
A production builder finishes more than half of their homes inside six months. A custom builder finishes a quarter of theirs. Nothing is pulled off a shelf, and every selection is a decision somebody has to make.
Where you build matters too. In the West, 51% of contractor-built homes took 13 months or more. In the Midwest, 16% did.
Add design, engineering, and permit review before the start date, and NAHB's analysis of the same Census data puts the average contractor-built home at roughly 12 months from permit approval to completion. Your builder's own history is a better predictor than any national average. Ask for it.
What does a custom home cost, and where does the money go?
NAHB's Cost of Constructing a Home survey put average construction cost at about $162 per square foot in 2024, with the finished lot accounting for 13.7% of the final sale price. Construction cost covers the house. It doesn't cover land, design fees, or financing.
Your construction budget splits roughly like this:
| Stage | Share of construction cost |
|---|---|
| Interior finishes | 24.1% |
| Major systems rough-ins | 19.2% |
| Framing | 16.6% |
| Exterior finishes | 13.4% |
| Foundations | 10.5% |
| Site work | 7.6% |
| Final steps | 6.5% |
| Other | 2.1% |
Interior finishes are the biggest single line. That's cabinets, flooring, trim, tile, and fixtures — the selections you make. It's also the phase where homeowners most often blow past their allowances.
One more number worth knowing: NAHB's 2026 study puts government regulation at 26.4% of the price of a new single-family home, or $131,734. Some of that lands in your budget as fees. Some lands in your schedule as waiting.
The custom home building process at a glance
| Phase | What you decide |
|---|---|
| 1. Budget and financing | What you can actually spend |
| 2. Lot selection | Where, and what the site costs to build on |
| 3. Choosing a builder | Who, and under what contract |
| 4. Design and plans | Layout, size, structure |
| 5. Selections | Every finish, fixture, and material |
| 6. Permits and pre-construction | N/A |
| 7. Site work through framing | Any change gets expensive from here |
| 8. Rough-ins through drywall | Last call on anything inside a wall |
| 9. Finishes and closing | Punch list, walkthrough, warranty |
Phases overlap. Selections start during design and run well into construction on most jobs.
Phase 1: Set your budget and line up financing
Your budget has three parts: land, construction, and everything else. That third bucket catches design fees, permits, utility hookups, landscaping, and financing costs.
Most custom builds run on a construction loan that converts to a mortgage when the house is done. The bank doesn't hand over the money at closing. It pays in stages as work gets finished, which is called a draw.
Build in a contingency of at least 10%. Something will come up in the ground, in the plans, or in your own mind halfway through.
For builders: this is the conversation that sets the tone for everything after it. A client who understands draws and contingency going in is a client who doesn't panic at the first change order. Walking them through this section before contract signing heads off more conflict than any clause you could add.
Phase 2: Find and evaluate your lot
Not all of a lot is buildable. Setbacks, easements, slope, soil conditions, tree ordinances, and utility access all shrink what you can put where.
Two lots at the same asking price can differ by six figures once site work gets priced. A flat lot with utilities at the street costs far less to build on than a sloped lot needing a retaining wall, a long driveway, and a septic system.
Get your builder to walk the lot before you buy it. That hour is the cheapest money you'll spend on the whole project.
Phase 3: Choose your builder and contract type
Vet builders on their current jobs, not their portfolio photos. Ask to visit an active site. Ask for references from clients whose builds went sideways, not the ones that went smoothly.
Then settle the contract. Custom homes are usually built one of two ways, and NAHB publishes standard forms for both:
- Fixed price. You agree on a number. The builder carries the risk if costs run over, and keeps the difference if they don't. You get certainty, and you pay for that certainty in the price.
- Cost plus. You pay actual costs plus an agreed fee or percentage. You carry the cost risk. You also see every invoice, which some homeowners prefer.
Neither is the honest one and neither is the trick. They move risk to different sides of the table.
For builders: this is the exact screening list a prepared client runs through before they sign. An active job site to visit, references who'll talk about a rough patch, a clear answer on fixed price vs. cost plus. Showing up ready for this conversation is most of the sale.
Phase 4: Design and plans
Design moves from rough sketches to construction documents over several rounds. Along the way you'll add a structural engineer, and sometimes a surveyor, a soils engineer, or a designer.
The mistake to avoid: designing in a vacuum and pricing at the end. A set of plans you love and can't afford means paying to redraw them.
Have your builder price the design while it's being drawn. Every round should come back with a number attached.
Phase 5: Make your selections
Selections are every product decision in the house — cabinets, counters, flooring, tile, plumbing fixtures, lighting, hardware, appliances, paint. Interior finishes are the largest slice of the construction budget, so this is where you either hold your number or lose it.
Two things to understand before you start.
Allowances are placeholders, not prices. Your contract may include a $12,000 lighting allowance. That's a budget line, not a lighting package. Pick fixtures that come to $19,000 and you owe the difference.
Late selections delay framing, not just finishes. Windows and exterior doors get ordered early. A tile decision can wait. Confusing the two costs weeks.
Ask your builder how they track selections. The good answer involves one place where every choice, its price, and your approval live together. Builders running software like Ressio show you the price difference against what was budgeted before you approve, so the overage conversation happens now instead of at closing. The bad answer is three email threads and a spreadsheet.
Phase 6: Permits and pre-construction
Your plans go to the local building department for review. Timelines vary by jurisdiction more than any other part of the process, from a couple of weeks to several months.
Nothing you do speeds this up. Use the time: finalize selections, lock the schedule, and hold a pre-construction meeting with your builder to walk the plans line by line.
That meeting is your last cheap chance to change your mind.
For builders: permit timelines are the one delay you can't fix and the one clients blame you for anyway. Setting the expectation early, and giving them something productive to do while they wait, heads off the weekly "why isn't anything happening" call.
Phase 7: Site work, foundation, and framing
Ground breaks. Excavation, footings, foundation, then framing goes up. Site work and foundations run about 18% of construction cost, framing another 17%.
This is the fun phase. Progress is visible week to week, and the house goes from a hole to a shape you can walk through.
It's also the last cheap moment for structural changes. Moving a wall on paper costs nothing. Moving it after it's framed costs framing labor twice, and possibly engineering.
Phase 8: Rough-ins, inspections, insulation, and drywall
Plumbing, electrical, and HVAC go into the walls, followed by inspections, insulation, and drywall. Major systems rough-ins are 19.2% of construction cost, the second largest stage.
This phase feels slow because the outside stops changing. Inside, it's the densest work in the build.
Walk the house before drywall goes up. Once the walls close, adding an outlet or moving a shower valve means cutting them open again.
Phase 9: Finishes, punch list, and closing
Cabinets, trim, paint, flooring, tile, and fixtures go in. Then the final stretch: a punch list, a walkthrough, and closing.
A punch list is the running list of items to fix or finish — a scratched counter, a door that sticks, a missing switch plate. You and your builder build it together during the final walkthrough.
At closing you'll get the certificate of occupancy, your warranty documents, and the keys. Ask what the warranty covers and for how long before you sign, not after.
For builders: the punch list and the warranty conversation are where trust either compounds or cracks, right at the finish line. Walking it together beats a list emailed over and it's one more thing your clients don't have to chase you for.
New home construction checklist
Use this checklist to track where you are and what to ask at each stage.
Before you buy land
- Confirm zoning, setbacks, and any HOA design review
- Check utility access and what hookups cost
- Have a builder walk the lot and estimate site work
- Confirm the lot works for the size of house you want
Before you sign a contract
- Visit an active job site
- Call references, including one difficult project
- Confirm license and insurance
- Understand whether it's fixed price or cost plus
- Read the allowance schedule line by line
Before construction starts
- Selections finalized, especially long-lead items
- Written schedule with milestones
- Draw schedule matched to those milestones
- Change order process agreed in writing
- Pre-construction meeting held
During construction
- Weekly update from your builder
- Every change order signed before work starts
- Site walk before drywall
- Allowance tracker current
Before closing
- Final walkthrough with punch list
- Certificate of occupancy issued
- Warranty documents in hand
- Lien waivers from subs and suppliers
What causes delays in custom home building?
Four things push custom home schedules: permit review, late selections, change orders, and weather. You control two of them.
Permit review is out of everyone's hands. NAHB's 2026 regulation study ties a measurable share of both cost and delay to zoning approval, design standards, permit and inspection processes, and code changes.
Late selections are the most common homeowner-caused delay. A cabinet order placed six weeks late doesn't slide the finish date six weeks — it slides everything scheduled behind cabinets.
Change orders cost time as well as money. Every one adds pricing, approval, and often a re-order. Weather you can't fix, but a builder who schedules with float absorbs it better than one who doesn't.
For builders: running this process with your clients
You've seen the pattern by now where every phase above is a moment your client could be asking you what's happening. Here's how to give them somewhere to look instead of answering it yourself every time."
Builders who run this well don't answer faster. They give clients somewhere to look.

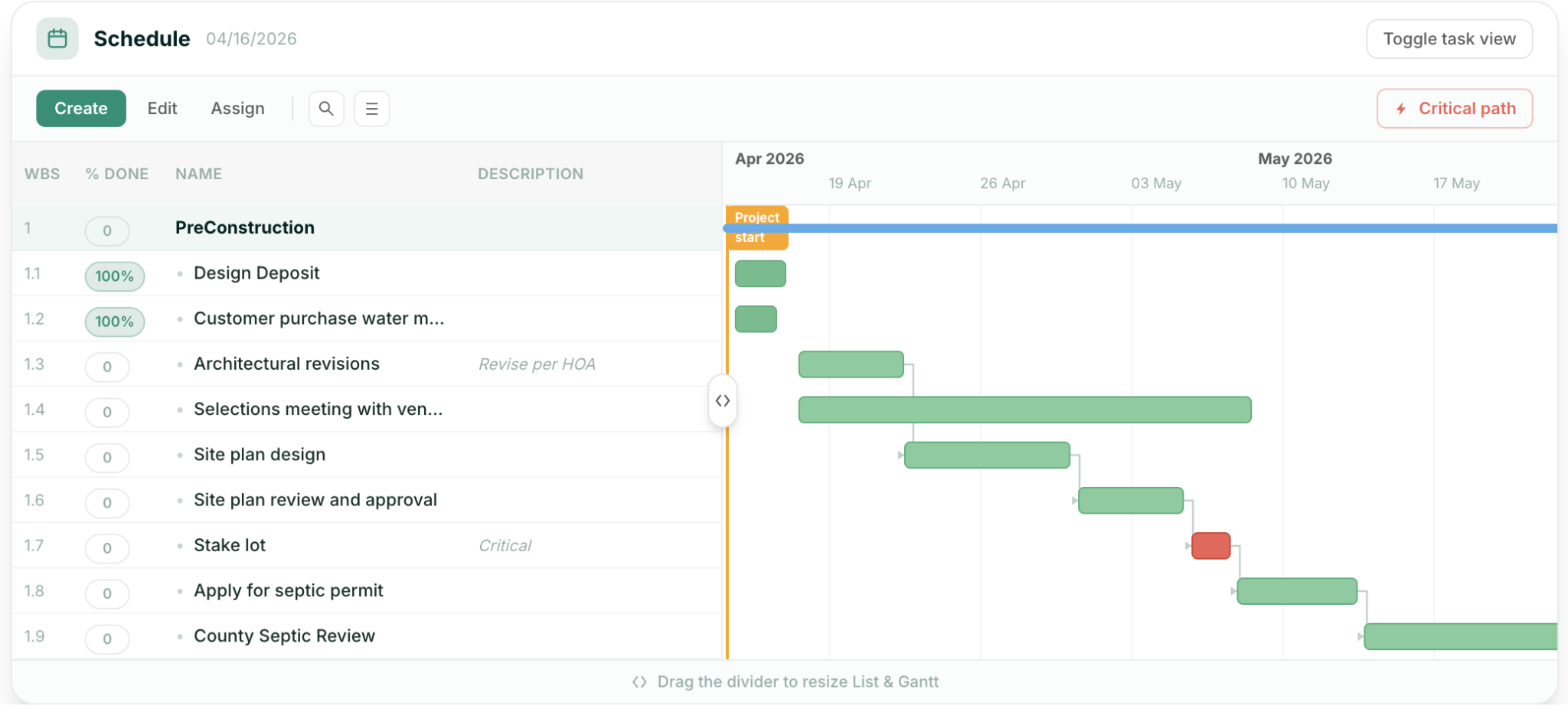

Ressio gives your clients a portal with the schedule, the selections they still owe you, and the change orders waiting on approval. Selections show the price difference against what was budgeted, so the overage conversation happens at approval instead of at closing.
Every approved selection and change order moves the budget on your side at the same time. The client's current price and your job cost stay the same number, which is the part that falls apart when selections live in email.
You get the rest from one place too: selections, change orders, and the schedule instead of four tools that don't talk.

Answering the same question from five clients every week? See how Ressio's client portal answers it for you.
Frequently asked questions
How long does it take to build a custom home?
Construction takes most custom homes seven months to over a year. Census Bureau data on homes completed in 2024 shows 29% of contractor-built homes took 13 months or more from groundbreaking, compared to 6% of production homes. Design, engineering, and permit review add several months before construction starts.
Do I need to buy land before I choose a builder?
No, and there's an argument for the reverse. A builder who walks the lot before you buy can tell you what site work will cost and whether the house you want fits. Buying first means finding out after the money is spent.
What's the difference between a custom home and a production home?
A custom home is designed for you and your specific lot, with no limits on layout or finishes. A production home comes from a builder's existing plan library with a set menu of options. Custom costs more and takes longer. Production is faster and cheaper because repetition is the point.
What happens if I change my mind during construction?
You sign a change order. It documents the change, the cost, and the schedule impact, and it should be signed before the work starts. Changes get more expensive the later they come. Moving a wall on paper is free; moving it after framing means paying for that framing twice.
What is an allowance in a custom home contract?
An allowance is a placeholder amount in your contract for a category you haven't chosen yet, like lighting or flooring. If your final selections cost more than the allowance, you pay the difference. Ask for the allowance schedule before you sign and check whether the numbers reflect what you actually want.
